The City of Detroit has a plan to transition to clean, renewable energy, making the City a more sustainable place to live for future generations of Detroiters. The Detroit Climate Strategy set goals for the City to generate enough clean energy to offset the usage of its core municipal buildings by 2034.

Mayor Duggan’s Solar Neighborhoods initiative is a significant step toward these goals, aiming to transform mostly vacant lots in Detroit neighborhoods into clean energy generation sites. DTE Energy was chosen to develop these solar sites, one of which is located in the Van Dyke/Lynch neighborhood.

This solar array will generate 10 megawatts of clean, renewable energy, offsetting a portion of the electricity required to operate City buildings such as City Hall, recreation centers, and police and fire stations. DTE will also work with the City to provide homes surrounding the solar array with valuable energy efficiency upgrades.



Project details

Click on the images below for more information on project landscaping, fencing and lighting.



Project milestones

DTE’s contractor will be using pile driving equipment to install the solar panel support structures starting January 7, 2026 through April 7, 2026 (or sooner). Workers will be on site from approximately 8 a.m. – 5:30 p.m., four days a week. This equipment hammers the supports into the ground and will be audible in the surrounding area. The peak noise made by this process will be below the decibel level of a common gas lawn mower. Please reference the video below to watch an example of the process.

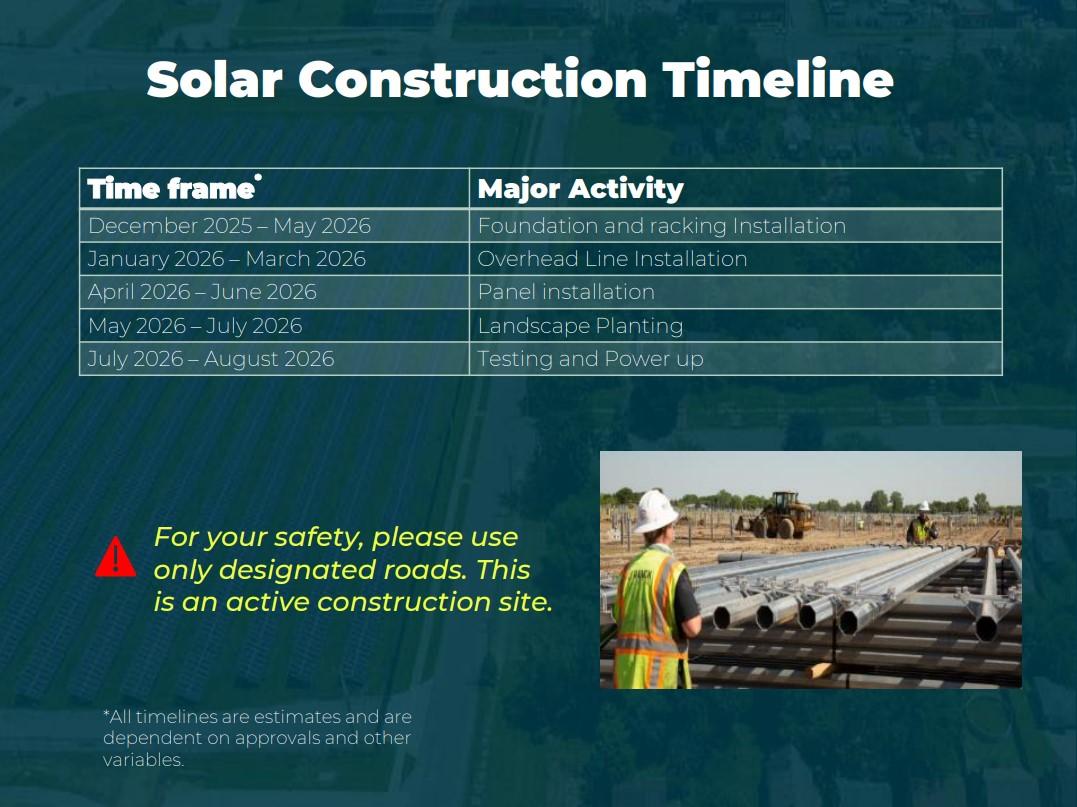

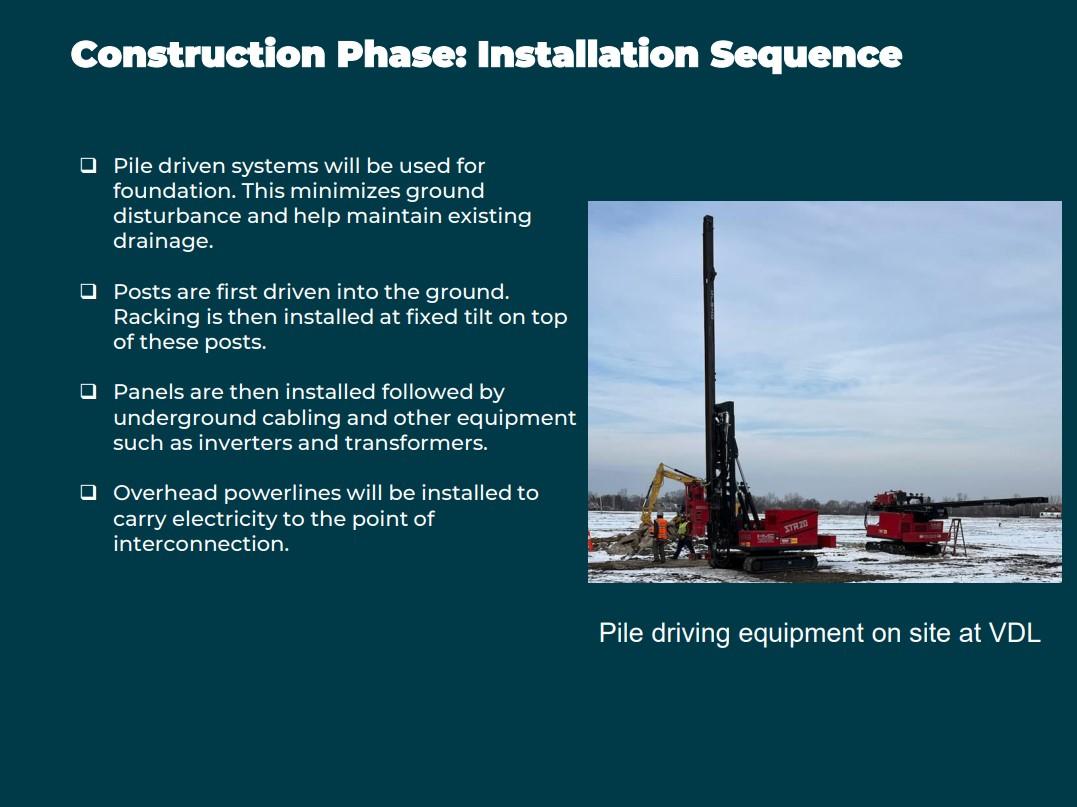

Click on the images below for more information on project construction and timelines.



Community engagement

Construction Update Meeting January 5, 2025

Watch the full January 5 construction update meeting here.

Pre-Construction Community Meeting August 25, 2025



Contact us
